How to Modify or Remove a Septic Covenant on Vancouver Island in 2025

If you own rural land on Vancouver Island, you’ve probably met the ghost of regulations past: a septic covenant buried in your title. These restrictive covenants are legacy items from a bygone era, and today they’re a common reason people can’t build the shop, suite, or accessory dwelling they want. The good news? They’re modifiable or removable — and in late 2025 the process is faster and more predictable than ever, routinely 5–10 weeks when done correctly.

Where Did These Covenants Come From?

Before May 31, 2005, BC’s old Health Act gave Island Health (and its predecessor, VIHA) direct authority over every septic system. When a new lot was created or a system permitted, the health authority frequently required a Section 219 covenant to be registered on title. This legally “reserved” the best piece of ground on the property exclusively for a future septic field, ensuring it could never be built on, paved, or filled.

The intent was solid public-health protection on a septic-dependent island, but the side effect is that thousands of properties still have these 30–50-year-old covenants locking up prime building areas today.

Everything changed in 2005 with the Sewerage System Regulation and the shift to a professional-reliance model. The Sewerage System Standard Practice Manual (now Version 3, released 2007 and updated since) made new covenants largely unnecessary. Health authorities stepped back from routine approvals, and today you’ll almost never see a new septic covenant registered. The ones that remain are almost entirely pre-2005 relics.

The Hard Rule in 2025: No Professional Letter = Automatic Rejection

Island Health will not even open your application unless it includes a Covenant Assessment Letter prepared and sealed by an Authorized Person under the Sewerage System Regulation — either a Registered On-site Wastewater Practitioner (ROWP) or a Professional Geoscientist (P.Geo.) with wastewater expertise.

No letter → instant refusal. No exceptions.

I’m a P.Geo. who has extensive experience altering and removing these covenants Island-wide. Here’s the exact four-phase process that works right now.

The Four Phases (Late 2025 Real-World Timelines)

Phase 1 – Technical Feasibility Assessment (2–4 weeks)

This is where 95% of applications live or die. Island Health requires unequivocal, field-verified evidence that:

1) The original covenanted area is no longer suitable, and

2) An alternate area for the proposed septic covenant area meets or exceeds current Sewerage System Regulation standards.

3) There is sufficient evidence that the site has many suitable options for placement of a septic system, and the covenant is able to be fully removed.

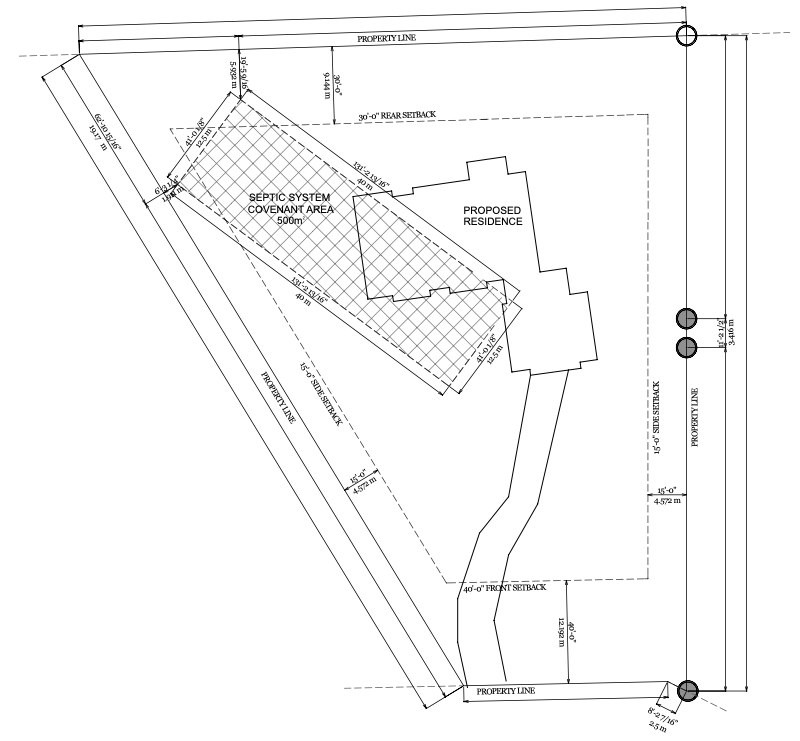

That means test pits, soil logs, percolation tests, seasonal water-table assessment, slope surveys, and a professional site plan. The resulting Covenant Assessment Letter must be data-rich, unambiguous, and leave nothing open to interpretation. When it’s done right, Island Health almost never asks for more information or a site visit.

Phase 2 – Covenant Release Package (1 week)

1) Current title & original covenant

2) Sealed Covenant Assessment Letter (P.Geo. or ROWP)

3) Land Title Form C – Release (prepared by your lawyer/notary)

4) $250 Island Health administrative fee

Phase 3 – Island Health Review (currently 1–2 weeks)

Covenant Release Package Submitted electronically → EHO reviews → Regional Manager signs → signed Form C emailed back.

Phase 4 – Land Title Registration (usually same week)

Your notary registers the release electronically and the covenant is gone.

Real-world result when the technical letter is bulletproof: 5–10 weeks total. My last three clients all successfully had Island Health septic system covenants removed in under 7 weeks.

P.Geo. vs ROWP: Why the Difference Matters More Than Ever

Both are legally authorized, but in practice the outcome is rarely equal:

- Professional Geoscientists are regulated specifically in hydrogeology, soil science, and contaminant transport — the exact disciplines Island Health scrutinizes on tricky lots (high water table, shallow/fractured bedrock, steep slopes, small parcels).

- Many ROWPs are outstanding designers and installers, but not all have the same depth in complex site hydrogeology or the professional weight that a P.Geo. seal carries when the reviewer has questions.

- On marginal or complicated sites I’ve personally seen applications rejected under a ROWP letter, then approved in under two weeks when resubmitted under my P.Geo. seal with no changes to the data.

Bottom line: a properly qualified P.Geo. dramatically reduces risk, follow-up requests, and total timeline.

The Fastest, Lowest-Stress Path

I’ve refined this process to the point where most covenants are gone in 5–8 weeks. I know exactly what Island Health wants to see in 2025 and how to present it so the reviewer can approve it the same day.

Most clients simply email me their PID (or civic address) and a copy of their title showing the covenant. I do a free desktop review within 48 hours and tell you straight up whether it’s straightforward or what specific fieldwork will be required. No charge and no obligation until we both agree to proceed.

If an old septic covenant is holding your property hostage, let’s get it altered or removed — properly, permanently, and as fast as Island Health will allow.

Send me your PID and title today and I’ll tell you within a couple of days exactly what it will take to get that covenant off your title for good.

Life’s too short to let a 40-year-old piece of paper dictate what you can do with your own land. Let’s fix it.
